Discovery found where invoicing slowed finance teams down
The first version came before any user testing, and access to users was limited. I led design through discovery, testing and launch. I started with the evidence I could reach: heuristic reviews, heat maps and a competitor review. The old system looked dated and sat apart from the platform. Users checked each invoice two or three times. With finance experts, I mapped the jobs to be done for the three roles in the approval chain.
One payment had seven readers: the transformation team, operators, the dry and wet teams, accountants, approvers and the client's customers. I built the information architecture around the Voyage, Fixture and COA Manager, so each cost sits on the voyage it belongs to.


A/B testing with 32 users built the case for a status dashboard over a share link
Leadership wanted to stop at invoice generation and send each invoice as a link by Slack, Teams or email. It was quick to build. I challenged the plan on data safety, privacy and how a team would track many links a day. I tested both versions with 32 users in interviews and A/B tests. Most chose the dashboard. I took the data to leadership and kept making the case until they dropped the link. The customer backed it too. The dashboard shows what waits for approval and what is approved. It took little extra build time.
A second test asked who gets invoiced for each cost. Version A used multi-fixture selection. Version B put the vessel and fixture on every row, and B shipped. Finance could see who gets invoiced without opening the fixture.

Progress and Notes gives each invoice an audit trail beside the document
I designed Progress and Notes as a panel beside each invoice. It lists every approval step and comment in the order the team works, from draft to payment recorded.

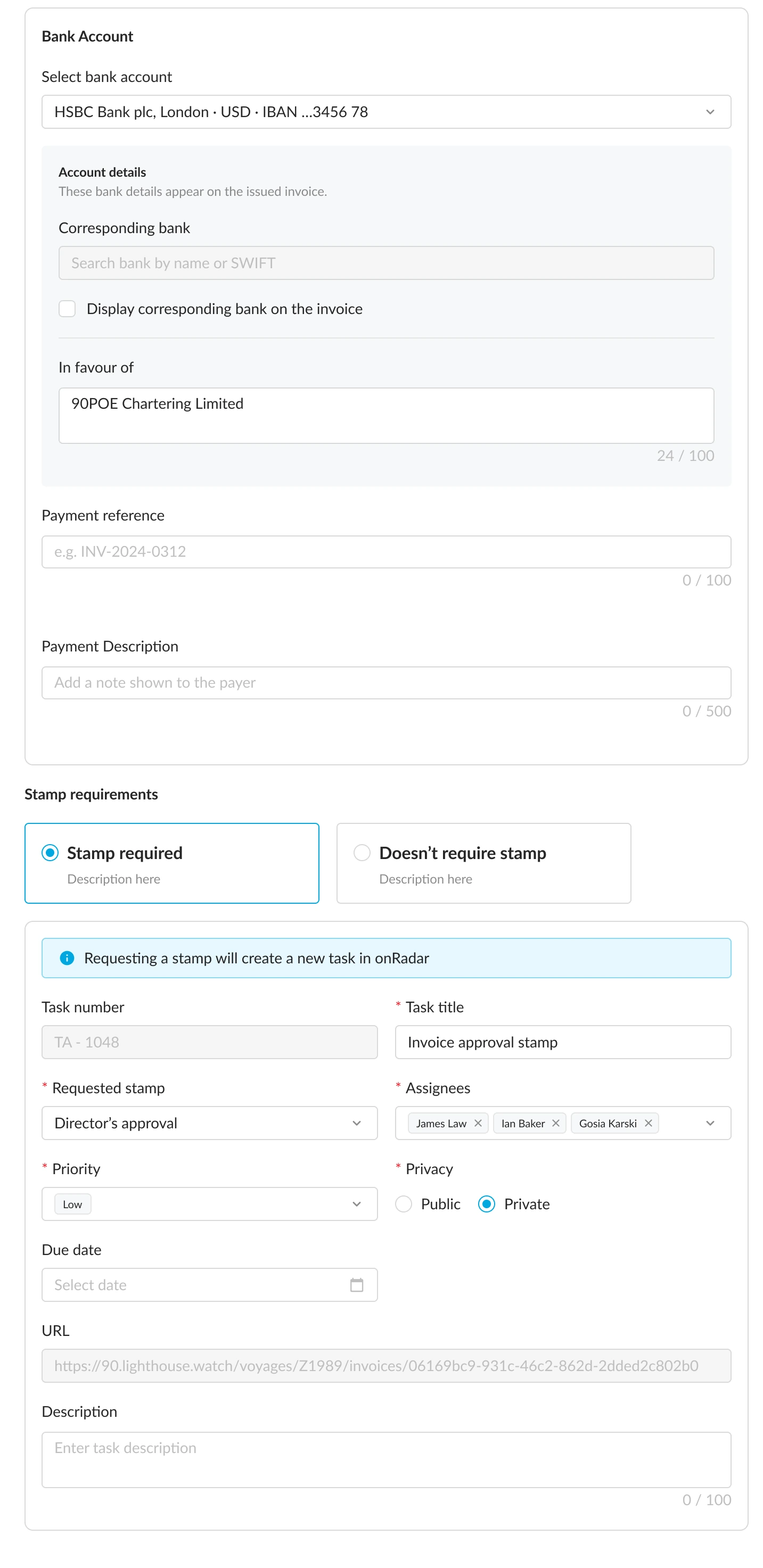

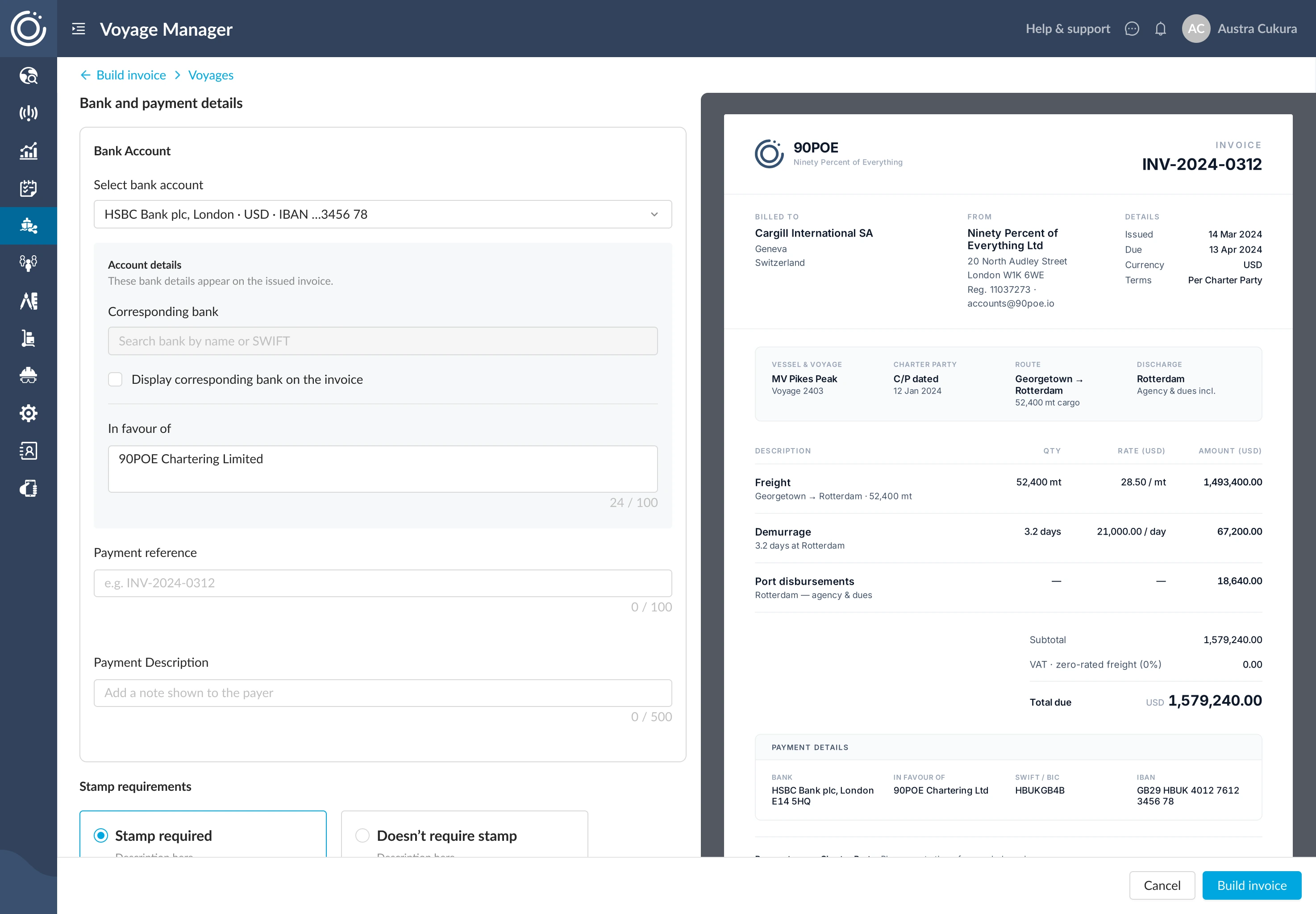

I designed a PDF preview so teams could see each invoice before it left
The old system gave teams no way to see an invoice before it went to the customer. I designed a PDF preview that updates live beside the form and proposed it for the MVP. Engineering estimated it beyond the deadline. I asked them what stood in the way. The backend work was new to the team. We added sprint time for a spike, and the preview shipped inside the MVP. Each customer got their own branding in a layout they knew, with the new features built in. Testing also led me to redesign a four-level sticky footer into one line of buttons.

A three-tier permission model sets who approves each invoice

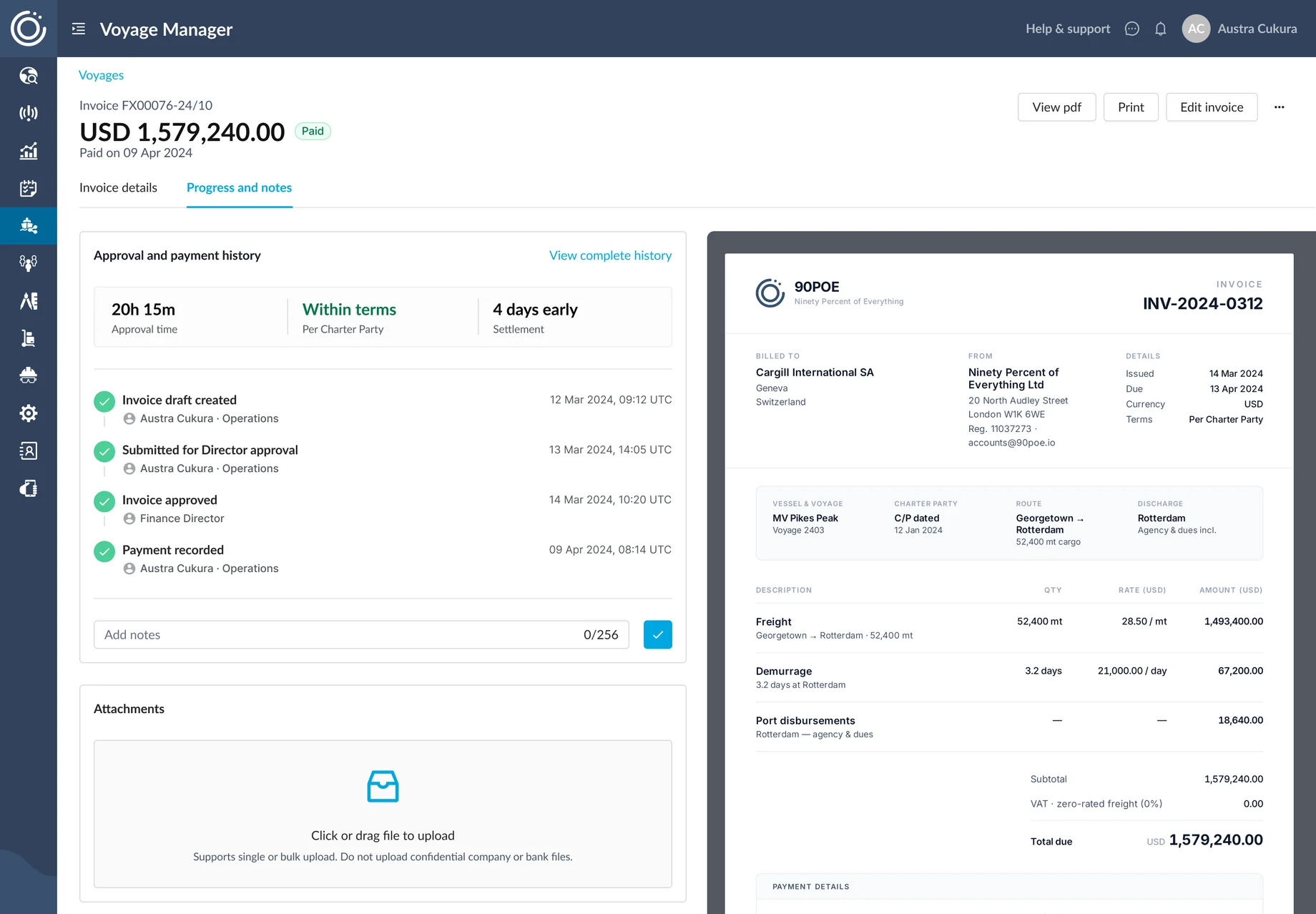

Two people check and approve each invoice before a director signs it off. The old system handled permissions well, and the new one had to match it. I built a three-tier permission model. Each person sees and acts on only what their level allows. The dashboard status updates by itself at each step.

$500M invoiced in five months, with every invoice out on time
In its first five months, the product invoiced $500M and sent 100% on time. The old and new systems ran side by side before switch-over. Every invoice matched. My design passed five sign-off stages, up to the C-suite on both sides. Two business units use the one product. Three other teams adopted the document pattern.
The design call that mattered most was one nobody asked for
Users asked to check each invoice before it left. Nobody asked for a preview. I designed one anyway, and users enjoyed it. The MVP came before research, so testing decided what changed. Now I decide with data, and I decide fast.
